main street and massachusetts avenue intersection
play

Main Street and Massachusetts Avenue Intersection West East to - PowerPoint PPT Presentation

Main Street and Massachusetts Avenue Intersection West East to Acton Concord Acquisition R Respo ponsibilities Address Map-Parcel Number Anticipated/Just Compensation ($) 243 Main Street G3-25 1,500 245 Main Street G3-22 7,800 246

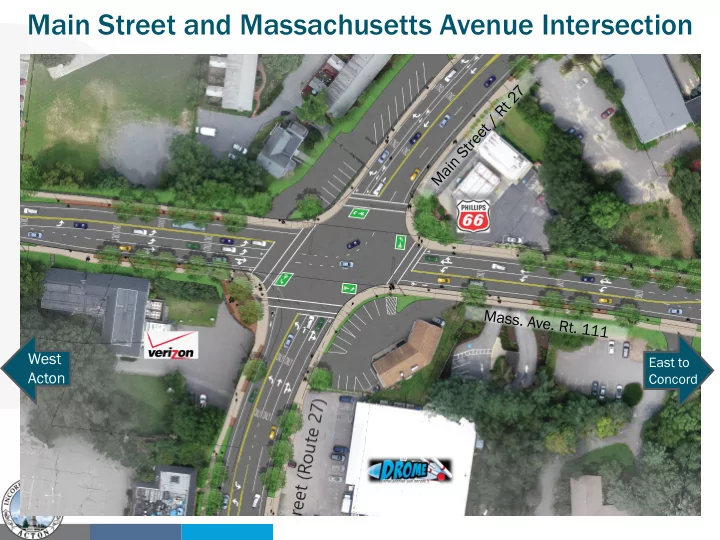

  1. Main Street and Massachusetts Avenue Intersection West East to Acton Concord

  2. Acquisition R Respo ponsibilities

  3. Address Map-Parcel Number Anticipated/Just Compensation ($) 243 Main Street G3-25 1,500 245 Main Street G3-22 7,800 246 & 248 Main Street G3-1, G3-21 & F3-140 49,750 247 Main Street G3-12 18,800 249 Main Street F3-133 15,525 253 Main Street F3-121-1 & F3-121-2 92,500 257 Main Street F3-121 85,600 282 Main Street F3-87 61,000 288 Main Street F3-88 34,300 289 Main Street F3-95 103,500 292 Main Street F3-80 18,900 300 Main Street F3-74 (donation)

  4. TOWN OF ACTON COST BREAKDOWN Acqui uisition T on Type ype Co Costs Fee Takings & Permanent Easements $314,700 Temporary Easements $174,475 Contingencies (Design Changes and Negotiated Amounts) $110,825 TOTAL $60 600, 0,00 000

  5. TOWN’S INVESTMENT LEVERAGES APPROXIMATELY 88% OF ESTIMATED TOTAL PROJECT COST State/Federal $17.2 M Town, $2.4 M • Engineering design To Town • Appraisal Services • Concept and • Right of Way engineering Acquisitions design • Construction Stat ate/ e/ • Appraisal Services Fed eder eral al • Right of Way Acquisitions • Pedestrian Light Poles

  6. BREAKDOWN OF TOWN’S INVESTMENT To Town State/F /Federal al Concept Planning $155,500 Engineering Design $756,000 $450,000 ROW Real Estate Appraisal Services $75,000 $75,000 Estimated Acquisition Costs $600,000 $2,520,000 Construction Costs - $14,718,378 Pedestrian Light Poles $815,000 TOTAL $2,401,500 $17,763,378

  7. MOVING FROM ENGINEERING TO CONSTRUCTION Ju July Dec ec. . Apr pril Dec ec. June 2 une 29th 2022 022 2020 020 2020 020 2021 2021 2020 020 Rig Right o of way y Tow own M Meeting process ss is • ROW A Authoriz ization Tow own M Meeting fin inal aliz ized Construction • Ac Acqui uisi siti tion Funds fundi ding g for State/Fed pedes destrian inves estm tment o t of 100% Des Design light poles $1 $14. 4.7 m 7 million Plan Pl ans MassD ssDOT Construction Advertisin ing Date

  8. Please Vote for Article 3 West East to Acton Concord

  9. CONSTRUCTION SCHEDULING AND PROCESS WHAT TO EXPECT • Mitig igat atin ing C Const structio ion I Impac acts - Residential and business owners - Communication • Day/N /Nig ight C Const structio ion H Hours s - Request for limited night work - Restricted work during commute hours - Duration of construction • AB B Sc School/Charter R Road ad - Request for realignment to occur during summer - Coordination with contractor, AB Schools and Police Department

  10. CONSTRUCTION SCHEDULING AND PROCESS WHAT TO EXPECT • Utili lity W Work rk Eversource Power - Notice is sent out several days in advance - A majority of area to have zero t to 15 min min. of outage time. - Three properties identified to have an estimated outage time of 4 4 to 8h 8hrs. Acton Water District - Service delays and interruptions are estimated less than a day when waterlines are switched over. National Grid - New plastic gas mains were installed in 2000. If gas leaks are found, they will be replaced.
