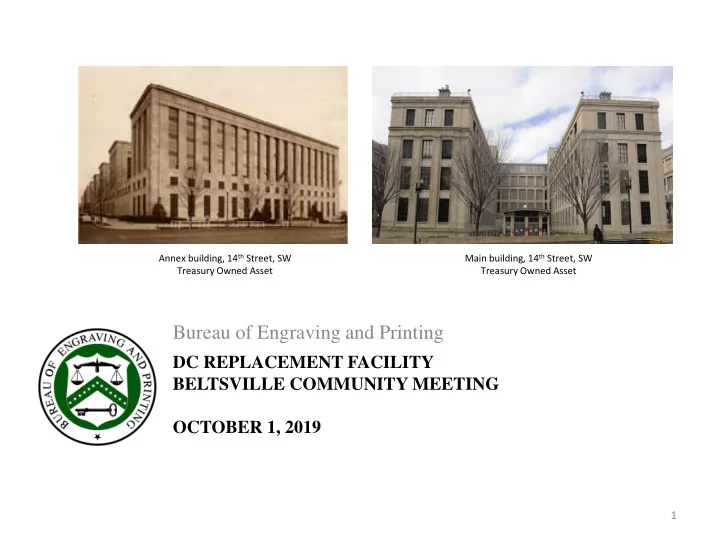

Annex building, 14 th Street, SW Main building, 14 th Street, SW Treasury Owned Asset Treasury Owned Asset Bureau of Engraving and Printing DC REPLACEMENT FACILITY BELTSVILLE COMMUNITY MEETING OCTOBER 1, 2019 1
About BEP Washington, DC Facility (DCF) Western Currency Facility (WCF) Main Building (1914) Annex Building (1938) Fort Worth, Texas (1991) Proud history Began operating in 1862 Became the sole producer of US currency in 1877 Two facilities: Washington, DC and Fort Worth, TX, with a leased warehouse in Landover, MD Number of employees: 1,800; (DCF 1,200) + (WCF 600) 15 unions and 19 bargaining units FY 2018 payroll – $225M FY 2019 Small Business Eligible contracts – $55M 2
Facility Program Summary Initial Phase: Construct a smaller, more-efficient replacement currency production facility within the National Capital Region Future Phase: Modernize the Main Building for BEP administrative functions and other government agencies Final Phase: Surplus Annex Building to reduce BEP’s footprint by 27% BEP would operate both the Main office building and new production facility 3
Current DC Facility Issues The Main and Annex buildings are 105 and 81 years old, respectively, with aging/outdated infrastructures that require costly maintenance Meeting the demand for currency and technological innovation must contend with: • Lack of flexibility in the facility for new production processes required to support currency redesign efforts and new anti-counterfeit security features • Multi-level manufacturing GAO review of BEP’s facility options confirmed a replacement production facility is the most economical facility solution 4
Replacement Facility Location Requirements Access to the interstate roadway system for transportation of currency to Federal Reserve Banks and commercial airports Highly-skilled workforce cannot be easily or quickly replicated outside of the National Capital Region without severe impact to the Nation’s money supply 216 Printers, Pressmen, Electro Machinists, and Book Binders: 4 – 8 year training program 8 Engravers: 5 – 10 year training program 5
Potential BARC Site USDA & Congress support BEP development on unused 100-acre site at the Beltsville Agricultural Research Center (BARC) in Maryland 2018 Farm Bill provided authority to transfer land parcel to BEP Majority of employees live in MD (64.8%) and of those, 43% reside in Prince George’s County 6
Potential BARC Site 200 Area Cluster of the BARC Central Farm Includes those buildings specifically used for poultry research 7
Potential Development Information Facility would be constructed on less than 2% of BARC’s existing acres Remediate and demolish approximately 24 abandoned facilities Facility approximately 850K – 1M square feet in size Typical height – 30’ to 40’ Facility access would be from Powder Mill Road Parking area will comply with NCPC planning figures • 6:30 am – 3:00 pm day shift; approx. 1,100 personnel • 2:30 pm – 11:00 pm evening shift; approx. 170 personnel • 10:30 pm – 7:00 am midnight shift; approx. 170 personnel Air and waste water treated onsite prior to discharge Storm water controlled onsite 8
BARC Program Benefits Removal of approximately 24 abandoned facilities – 4% reduction of BARC footprint • Reduction of maintenance and reporting costs All infrastructure improvements required to support BEP would be funded by the project Potential for cooperation on community services • Shared shuttle on campus and to DC HQ offices • Childcare • Law enforcement cooperation Increased BARC site utilization by hosting another federal agency 9
Replacement Facility Program Logistics When: Design to construction will take approximately 10 years; replacement facility rolling operational start-up from 2025 to 2029. Main building renovation completion – 2030/31. Disposition of Annex building to occur after renovation of the Main building. 2020 2029 2016 2025 2031 Begin Complete Develop Architectural Begin Transition Surplus Building & Engineering Transition to to New Annex Program Design New Facility Facility Building 2019 2022 2028 2030 Finalize Site Begin New Complete Begin Main Selection Facility Building Main Construction Renovation Building Renovation 10
Ft. Worth, Texas Community Involvement Awarder/Regulator Award Date Reason Award/Program Name Pollution Prevention Award October 6, 1999; December 8, 2005; November 7, 2007; In recognition of the significant efforts in the use City of Fort Worth November 11, 2009; November 8, 2012; December 3, 2015; of materials, processes or practices that reduced Water Department December 1, 2016; December 6, 2017; November 7, 2018 or eliminated wastes and which served to protect natural resources and our environment. Pretreatment Star Award October 25, 2001; December 2, 2010 For 100% compliance for one year with local, City of Fort Worth State, and Federal pretreatment regulations. Water Department Pretreatment Associate Award October 24, 2002; November 10, 2004; November 10, 2011 For 100% compliance for two consecutive years City of Fort Worth with local, State, and Federal pretreatment Water Department regulations. Pretreatment Partnership Award November 13, 2003; December 8, 2005; November 9, 2006; For 100% compliance for 3-10 consecutive years City of Fort Worth November 7, 2007; November 19, 2008; November 8, 2012; with local, State, and Federal pretreatment Water Department November 2013; November 13, 2014; December 3, 2015; regulations. December 1, 2016; December 6, 2017; November 7, 2018 Water Conservation Partner Award November 8, 2012 In recognition of our commitment to achieve and City of Fort Worth Water Department maintain water efficiency in operations through process refinement and fixture retrofit. ISO 14001 Certificate Date of certification: June 27, 2018 The original Certificate was issued on November ISO 14001 Valid Through: June 26, 2021 20, 2006. Most recent certification is to new standard ISO 14001: 2015 11
Ft. Worth, Texas Community Involvement In support of the Fort Worth and Tarrant County public and independent school districts, the BEP participates in the Adopt-a-School Program by volunteering in the following areas: • Assisting with field trips, projects, and contests • Promoting academic or social programs • Grooming students for the workforce • Supporting after-school groups • Mentoring or tutoring students both individually or in small groups • Honoring students and/or staff for their achievements BEP partners with the following schools of higher learning: • Texas Tech University – Edward E. Whitacre, Jr. College of Engineering • University of Texas at Arlington – College of Engineering • Southern Methodist University – Hart Center for Engineering Leadership • Texas State University • Texas Christian University – Department of Engineering 12
Questions and Discussion 13
