planning approaches
play

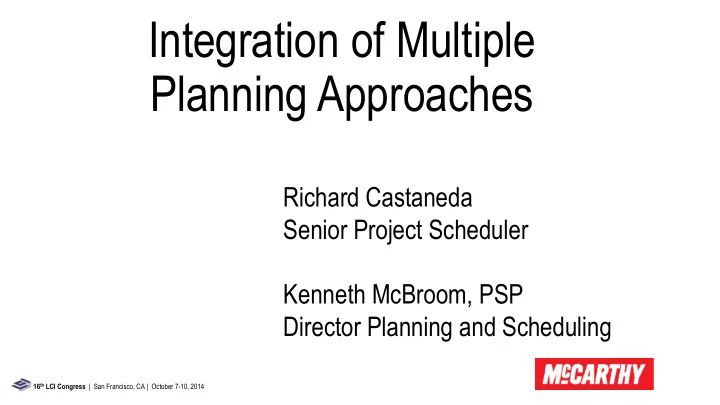

Planning Approaches Richard Castaneda Senior Project Scheduler - PowerPoint PPT Presentation

Integration of Multiple Planning Approaches Richard Castaneda Senior Project Scheduler Kenneth McBroom, PSP Director Planning and Scheduling 16 th LCI Congress | San Francisco, CA | October 7-10, 2014 Questions How does a Large


  1. Integration of Multiple Planning Approaches Richard Castaneda Senior Project Scheduler Kenneth McBroom, PSP Director Planning and Scheduling 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  2. Questions • How does a Large Construction Project Integrate Various and Very Different Scheduling Approaches? • What if that project is a 100% Design / Build Project? • And it is Hospital? • On an Existing Fully Functioning Hospital Campus? • In California under the Authority of ? 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  3. North West Tower – Project Background Prior to NWT Construction 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  4. North West Tower – Project Background Prior to NWT Construction 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  5. North West Tower – Project Background Schedule Data • Jan 2011 – Site Make Ready 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  6. North West Tower – Project Background Schedule Data • August 2011 – Demo of (e) Parking Garage 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  7. North West Tower – Project Background Schedule Data • May 2012 – Structural Steel for NWT 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  8. North West Tower – Project Background Schedule Data • August 2014 – Original Contract Completion 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  9. CPM – the What • Required by Contract; Used to Determine Key Milestone Dates • Approximately 6500 Activities • Resource Loaded • Not Cost Loaded 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  10. Location Based Scheduling (LBS) – the Where • VICO was required by Contract • BIM Software - Utilizes Location Based Scheduling - Utilizes 3D Model (DWG, SKP, DWF) 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  11. Location Based Scheduling LBS Process Overview: Step 1 Break the Project into Locations • Levels 1,2,4,5 • West & East or North & South ? Location Breakdown Structure 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  12. Location Based Scheduling LBS Process Overview: Step 2 Create Tasks that matched the CPM but based on Location 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  13. Location Based Scheduling 2011 2012 AUG SEP OCT NOV DEC JAN FEB MAR APR MAY 15 22 29 5 12 19 26 3 10 17 24 31 7 14 21 28 5 12 19 26 2 9 16 23 30 6 13 20 27 5 12 19 26 2 9 16 23 30 7 14 6 th 5 th Location (Floors) 4 th Continuous flow • Activities continuous 3 rd but start later 2 nd 1 st 5 10 15 20 25 30 35 Weeks Start later when work can proceed continuously 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  14. Location Based Scheduling 2011 2012 AUG SEP OCT NOV DEC JAN FEB MAR APR MAY 15 22 29 5 12 19 26 3 10 17 24 31 7 14 21 28 5 12 19 26 2 9 16 23 30 6 13 20 27 5 12 19 26 2 9 16 23 30 7 14 6 th - OH MEP 5 th Location (Floors) - OH MEP 4 th Task: Activities - OH MEP 3 rd - OH MEP 2 nd - OH MEP Crew Flow 1 st - OH MEP 5 10 15 20 25 30 35 3 weeks Weeks Flowline: graphical representation of movement of crews over time 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  15. Location Based Scheduling LBS Process Overview: Step 3 Assign Quantities to the task from the Model 3D Based Quantities 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  16. Location Based Scheduling LBS Process Overview: Step 4 Input the Production Rates and Crew Sizes for all the trades to Determine Durations 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  17. Location Based Scheduling Aligning the CPM Schedule in LBMS 2,432 Activities Converted into 372 Tasks 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  18. Location Based Scheduling No Work Occurring Trade Stacking 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  19. Location Based Scheduling Optimization  Used LBS to produce an Optimized Work flow for all trades  Had to revise the Baseline to Match the Dates in LBS  Tolerance = +/- 2 days 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  20. Location Based Scheduling Production Control – Weekly Updating 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  21. Location Based Scheduling Weekly - Input Quantity put in place - Completion Report - Review Target Production & Actual Production 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  22. Location Based Scheduling Late start Behind On-time Complete 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  23. Location Based Scheduling 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  24. Location Based Scheduling Control Action Plan (Note for Every Alarm) 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  25. Last Planner System Pull Planning – the How 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  26. Last Planner System 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  27. 4D Scheduling 4D Scheduling – what it will look like • Utilizes CPM Scheduling • Compatible w/ Primavera P6 • Utilizes 3D Model (DGN, DWG, SKP, DWF) • Creates 4D Animation • Show the status of the Project at any point in time 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  28. 4D Scheduling CPM LBS 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  29. 4D Scheduling 4D Development - Import Schedule & Model - Link Task with 3D Elements - Add Equipment - Generate 4D Animation 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  30. 4D Scheduling Safety - Identify current site conditions - Identify high risk area (Path of travel for concrete trucks) 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  31. 4D Scheduling Safety - Identify crane set-up / location - Identify danger area (Swing Radius) - Blind Spots Created by the Construction 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  32. 4D Scheduling How does Link Piping (Piping from CUP to Tower) affect Deck Pours? 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  33. 4D Scheduling 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  34. 4D Scheduling 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  35. 4D Scheduling - Displays conflict with original logic - Avoided schedule & cost impacts (Approx. $105,000) 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  36. 4D Scheduling Improved Communication - Displays work that is complicated to describe in the schedule - Avoids confusion 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  37. 4D Scheduling Improved Communication - Closed temp road and opening of a new access road - Identified Potential Problem with U/G Plumbing Pipe Delivery 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  38. 4D Scheduling Improved Communication – Owner (Disruption Notices) - Displays work to be performed - Displays equipment outside construction area - Identifies traffic control personal 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  39. 4D Scheduling Improved Communication – Owner (Schedule Progress) 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  40. North West Tower – Project Completion 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  41. North West Tower – Project Background 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  42. North West Tower – Project Completion 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  43. North West Tower – Project Completion 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  44. North West Tower – Project Completion 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  45. North West Tower – Project Completion 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  46. Integration 4D – WHAT/WHEN CPM – WHAT Pull Planning – HOW LBS – WHERE 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  47. CPM-the WHAT Provides planned work breakdown structure, with key milestones Typically created in Push manner Created early in process CPM – P6 Schedule 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  48. LBS-the WHERE Identified in P6 where Remaining Durations should be Modified to account for real world production Helped Create a Better Master Plan Provides “should start” dates rather than CPM – P6 Schedule CPM early start or late start dates Ensures continuous work between locations Identified bottle necks & inefficiencies 16 th LCI Congress | San Francisco, CA | October 7-10, 2014

  49. PULL – the HOW Communication – Trades; Last Planners of the Work Create Daily Measurable Detailed Used CPM Milestones to Tasks and then held the Trades Create 3 to 6 Week Detailed accountable Schedules CPM – P6 Schedule Actuals in P6 would Reflect the Promises Kept by the Trades Flushed Out Field Conflicts Pull Planning and Issues Prior to starting the work 16 th LCI Congress | San Francisco, CA | October 7-10, 2014
