lincoln heights
play

Lincoln Heights Storm Drainage Improvement Project Existing - PowerPoint PPT Presentation

Lincoln Heights Storm Drainage Improvement Project Existing Conditions Public Meeting Steven McCraney Project Manager Phone 704-432-0967 Email smccraney@charlottenc.gov May 6, 2014 Armstr strong Glen Beatties Ford Road Regional

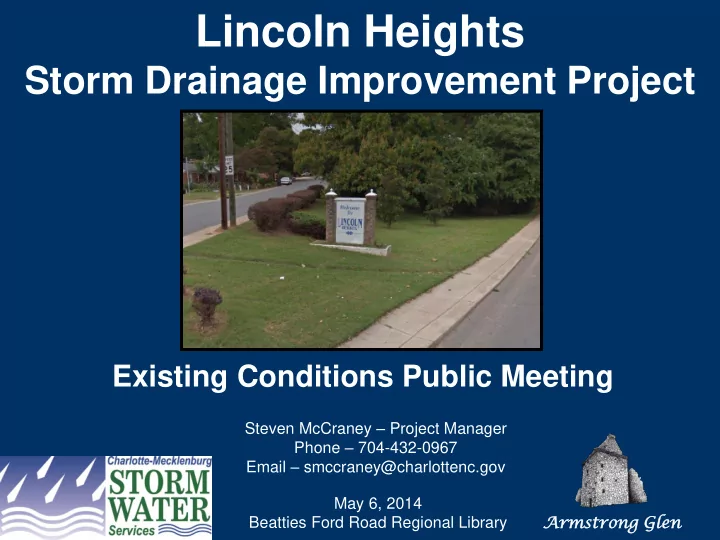

  1. Lincoln Heights Storm Drainage Improvement Project Existing Conditions Public Meeting Steven McCraney – Project Manager Phone – 704-432-0967 Email – smccraney@charlottenc.gov May 6, 2014 Armstr strong Glen Beatties Ford Road Regional Library

  2. WELCOME AND INTRODUCTIONS Charlotte-Mecklenburg Storm Water Services (CMSWS) Staff Steven McCraney – Project Manager Phone: 704-432-0967 E-mail: smccraney@charlottenc.gov Doug Lozner – Watershed Area Manager Armstrong Glen Staff Josh Letourneau – Project Manager Russell Parker – Project Engineer Arms mstro trong g Glen len

  3. MEETING PURPOSE • Provide a summary of the Existing Conditions analysis. • Request input from property owners/residents on the Existing Conditions analysis results. • Obtain additional information from property owners/residents on perceived drainage issues.

  4. MEETING AGENDA • Project Selection and Citizen Involvement • Existing Conditions Analysis Summary • Future Project Milestones – Path Forward • General Questions and Comments

  5. PROJECT SELECTION AND CITIZEN INVOLVEMENT Why was the Lincoln Heights area chosen? • Requests for service from property owners 56 TOTAL REQUESTS REPORTED TO 311 IN THIS NEIGHBORHOOD Example Requests: • Inadequate and Deteriorating Infrastructure • Road Flooding • First Floor & Crawl Space Flooding • Old Culverts, Pipes, Inlets • Sink Holes • Erosion, Blockages in Streams • Larger watershed-wide issues that cannot be managed by spot repairs or without potentially impacting downstream properties

  6. LINCOLN HEIGHTS STORM DRAINAGE IMPROVEMENT PROJECT Existing Conditions Analysis Results Presented by: Armstro trong ng Glen, , P.C. Civil Engineers

  7. EXISTING CONDITIONS RESULTS MAP • Highlights undersized storm systems • Highlights storm systems that are structurally deficient. (determined from pipe video) • Summarizes 311 Requests filed by residents.

  8. EXISTING CONDITIONS RESULTS MAP GILBERT ST. HOLLY ST.

  9. EXISTING CONDITIONS RESULTS MAP

  10. EXISTING CONDITIONS RESULTS MAP HAINES ST. IRMA ST. CATHERINE SIMMONS AVE. KENNESAW DR. JENNINGS ST. ERIE ST. LA SALLE ST..

  11. EXISTING CONDITIONS RESULTS MAP ODESSA AVE. KENNESAW DR. JENNINGS ST. MADRID ST.

  12. STORM DRAINAGE IMPROVEMENT PROJECT PHASES PLANNING (Typically 12 to 27 months) • Existing Conditions Analysis – Finding the Problems (Current Phase) • Alternative Analysis – Developing Alternative Improvements DESIGN (Typically 21 to 34 months) • Designing the Improvements PERMITTING (Typically 9 months, but usually overlaps the design phase) EASEMENT ACQUISITION (Typically 12+ months) BID (Typically 5 to 6 months) CONSTRUCTION (From 1 to 2+ years)

  13. PATH FOWARD • Additional information obtained during this meeting will be considered and incorporated into the existing conditions analysis, where applicable. • Alternatives will be evaluated, and a recommended alternative will be developed. • Charlotte-Mecklenburg Storm Water Services will hold a second public meeting to present and obtain feedback on the recommended alternative.

  14. Questions? Thank you for coming to the meeting! Please remember to sign-in and fill out a customer service card.
