proposed complete streets improvements
play

Proposed Complete Streets Improvements S. Walter Reed Drive from 5 th - PowerPoint PPT Presentation

Proposed Complete Streets Improvements S. Walter Reed Drive from 5 th Street S. to 9 th Road S. Penrose & Arlington Heights Civic Association 2015 Northbound on S Walter Reed Dr March 19, 2016 9:00 AM at Thomas Jefferson Theatre Project

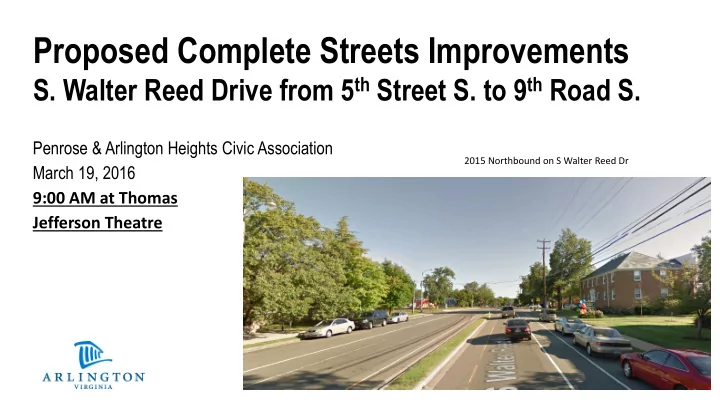

  1. Proposed Complete Streets Improvements S. Walter Reed Drive from 5 th Street S. to 9 th Road S. Penrose & Arlington Heights Civic Association 2015 Northbound on S Walter Reed Dr March 19, 2016 9:00 AM at Thomas Jefferson Theatre

  2. Project Location

  3. Where we are in the process… Project Phases Scope & Concept Engineering Design Construction Development • Plans are at 60% complete • Working on obtaining real estate easements • Working through 60% design comment resolution

  4. Project Purpose & Objectives • Create permanent improvements to painted road diet and to address existing speeding issues • Full complete streets project • Our intention is to move forward to construction as soon as possible • To implement as many of the scope elements as possible • If we are unable to obtain easements, the improvements that require those easements will be removed from the project

  5. Major Scope Elements & Improvements • Major intersection redesign at 5 th St and 9 th St. • Driveway and access redesign at 8 th St S • Intersection nubs and drainage improvements • New bus stops • Landscaping in the raised medians and possibly large curb extensions • Paving the section needed for widening • Install new pavement markings and signage • Replacing cracked sections of sidewalk

  6. Critical Easements • 12 Temporary Construction • Working with Engineering and Real Estate • Will be notifying and speaking with property owners very soon

  7. Other Adjacent Projects • Separate from S. Walter Reed Complete Street Project • Bikeshare station in front of Patrick Henry at 8 th Street • Bioretention at 5 th Street (NW) and 9 th Street (SE) • Traffic signal at 7 th Street • Traffic signal at 9 th Street

  8. Next Steps & Milestones – • Civic engagement of 60% plans – March 2016 • Utility relocation coordination – ongoing. throughout 2016 • Easement acquisition – ongoing. throughout 2016 • 90% design plans – August 2016 • Informational presentation of 90% plans – September 2016 • 100% design plans – November 2016 • County construction permits – January 2017 • Procurement & Advertisement – December to March 2017 • Construction award – May 2017 • Construction completion – June 2017 to March 2018

  9. Questions or Comments?
