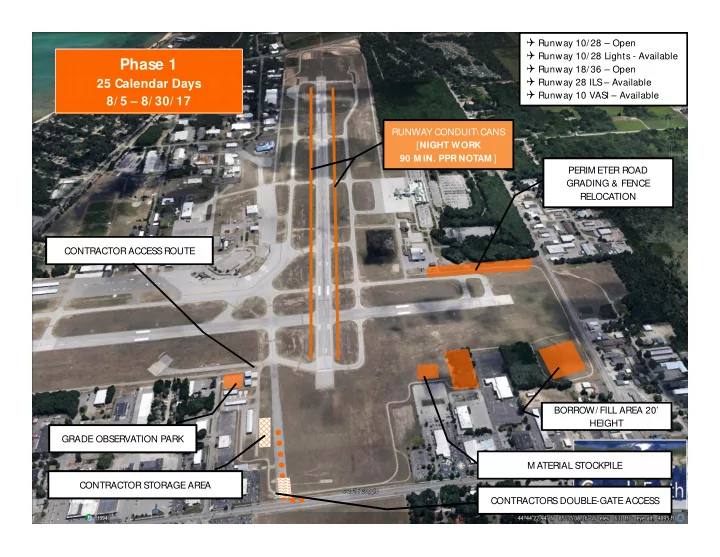

Phase 1 Q Runway 18/ 36 Open Q Runway 28 ILS Available 25 Calendar - PowerPoint PPT Presentation

Q Runway 10/ 28 Open Q Runway 10/ 28 Lights - Available Phase 1 Q Runway 18/ 36 Open Q Runway 28 ILS Available 25 Calendar Days Q Runway 10 VASI Available 8/ 5 8/ 30/ 17 RUNWAY CONDUIT\ CANS [ NIGHT WORK 90 M IN. PPR NOTAM ]


  1. Q Runway 10/ 28 – Open Q Runway 10/ 28 Lights - Available Phase 1 Q Runway 18/ 36 – Open Q Runway 28 ILS – Available 25 Calendar Days Q Runway 10 VASI – Available 8/ 5 – 8/ 30/ 17 RUNWAY CONDUIT\ CANS [ NIGHT WORK 90 M IN. PPR NOTAM ] PERIM ETER ROAD GRADING & FENCE RELOCATION CONTRACTOR ACCESS ROUTE BORROW/ FILL AREA 20’ HEIGHT GRADE OBSERVATION PARK M ATERIAL STOCKPILE CONTRACTOR STORAGE AREA CONTRACTORS DOUBLE-GATE ACCESS

  2. Q Runway 10/ 28 – Open Q Runway 10/ 28 Lights - Available Q Runway 18/ 36 – CLOSED Phase 2 Q Runway 28 ILS – Available 6 Calendar Days Q Runway 10 VASI – Available 8/ 26-9/ 1/ 17 INSTALL SIL T FENCE & GRADE PERIM ETER ROAD CONSTRUCT PORTION OF TAXIWAY D CLOSE RUNWAY 18-36 PPR – TOWED AIRCRAFT ACCESS NON-M OVEM ENT LINE

  3. Q Runway 10/ 28 – OPEN 6008’ Q Runway 10/ 28 Lights - Available Phase 3 Q Runway 18/ 36 – Open Q Runway 28 ILS – EST . OTS 9/ 7 10 Calendar Days Q Runway 10 VASI – OTS 9/ 4-9/ 14/ 17 RUNWAY 10-28 TEM PORARY THRESHOLD M ARKING AND LIGHTS (6,008’ X 150’) VASIs OTS EXTEND TAXIWAY G CONSTRUCT BLAST P AD, M ALSR THRESHOLD AND EXTEND TAXIWAY D FOUNDATIONS, RSA GRADING

  4. Q Runway 10/ 28 – CLOSED Q Runway 10/ 28 Lights - OTS Phase 4 Q Runway 18/ 36 – Open Daytime Q Runway 28 ILS – OTS 1.5 Calendar Days Q Runway 10 VASI – OTS 9/ 15-9/ 16/ 17 RUNWAY 10-28 CLOSED RESURFACING 5,000’, INSTALL P API RECONSTRUCTION OF 800’ FOUNDATIONS P AVEM ENT , (OUTSIDE RWY 18/ 36 RSA) NEW DISTANCE REM AINING SIGNS, NEW EDGE LIGHTING SYSTEM CONSTRUCT P AVED SHOULDERS W/ IN RUNWAY 18/ 36 RSA [NIGHT WORK 90 M IN.PPR NOTAM ] RUNWAY 18-36 CLOSED 2300-0600 HOURS TAXIWAY C CLOSED DAYTIM E BACK TAXI ON RUNWAY 18/ 36

  5. Q Runway 10/ 28 – CLOSED Q Runway 10/ 28 Lights - OTS Phase 5 Q Runway 18/ 36 – Open Q Runway 28 ILS – OTS 14 Calendar Days Q Runway 10 VASI – OTS 9/ 15-9/ 29/ 17 RESURFACING 5,000’, RECONSTRUCTION OF 800’ P AVEM ENT , RESURF ACE SHOULDERS, NEW DISTANCE REM AINING SIGNS, NEW EDGE LIGHTING SYSTEM , TEM PORARY M ARKINGS INSTALL P API [NIGHT WORK] CONSTRUCT PAVED SHOULDERS WITHIN RSA OF BOTH RUNWAYS [NIGHT WORK] RUNWAY 18-36 CLOSED 2300-0600 HOURS EST . 2 NIGHTS CONSTRUCT 115’ EXTENSION RUNWAY 10-28

  6. Q Runway 10/ 28 – Open Q Runway 10/ 28 Lights - Available Q Runway 18/ 36 – Open PAVEM ENT CURING Q Runway 28 ILS – Available (~20 Days After Paving) Q Runway 10 PAPI – Available 9/ 27-10/ 17/ 17 RUNWAY 10-28 NO RUNWAY GROOVING OR POROUS FRICTION COURSE P API FLIGHT CHECK EST. 9/ 29/ 17 ILS FLIGHT CHECK EST. 9/ 29/ 17

  7. Q Runway 10/ 28 – DAYTIM E Q Runway 10/ 28 Lights - Available Q Runway 18/ 36 – Open Phase 6 Q Runway 28 ILS – Available 16 Calendar Days Q Runway 10 P API – Available (~20 Days After Paving) 10/ 17-11/ 2/ 17 RUNWAY 10-28 CLOSED 2300-0600 HOURS 90 M INUTE PPR GROOVE & P AINT RUNWAY 10-28 (~20 DAYS AFTER P AVING)

  8. Q Runway 10/ 28 – Open Q Runway 10/ 28 Lights - Available Q Runway 18/ 36 – Open Phase 7 Q Runway 28 ILS – Available 10 Calendar Days Q Runway 10 P API – Available 9/ 13-9/ 23/ 17 REM OVE TEM PORARY FENCE AND COM PLETE PERIM ETER ROAD WORK

  9. Q Runway 10/ 28 – Open Q Runway 10/ 28 Lights - Available Q Runway 18/ 36 – Open Phase 8 Q Runway 28 ILS – Available 21 Calendar Days Q Runway 10 P API – Available 9/ 29-10/ 20/ 17 CONSTRUCT M ALSR SYSTEM AND SERVICE ROAD CONSTRUCT PRIVACY FENCE

  10. Q Runway 10/ 28 – Open Q Runway 10/ 28 Lights - Available Q Runway 18/ 36 – Open POST CONSTRUCTION Q Runway 28 ILS – Available Q Approach Published Q Runway 10 P API – Available (1 M i.+ M inimums) Dec 2017 Q M ALSR Operational Early 2018 – Pending Tree 000000000 Clearing 00000 Q Approach Amendment 00000 (3/ 4 M i. M inimums) 00000 M arch 2018 00000 00000 00000 00000 00000 00000
